How Long Does a Bathroom Remodel Take? A Week-by-Week Timeline for Greater Boston
How long does a bathroom remodel take? A realistic week-by-week timeline for Somerville and Cambridge homes, from design and permits to final inspection.

How long does a bathroom remodel take? On my jobs in Somerville and Cambridge, a typical full bathroom takes about 3 to 5 weeks of construction, plus a few weeks of design, ordering and permits before anyone picks up a hammer.
So from first meeting to final inspection, most homeowners should plan on roughly two to three months. Here's how that time breaks down, what slows it down, and how to survive it if it's your only bathroom.
How long does a bathroom remodel take? The short answer
These are the ranges I plan around for a standard full bathroom in an older Greater Boston home. Your project may be shorter or longer.
| Phase | Typical time on my jobs |
|---|---|
| Walkthrough, design and selections | 1 to 3 weeks |
| Ordering fixtures and tile | 2 to 6 weeks (overlaps with permits) |
| Permits | Up to 30 days by state code, often sooner |
| Construction | 3 to 5 weeks |
| Final inspections and punch list | About 1 week |
Before demo: design, ordering and permits
The fastest bathrooms are the ones fully planned before demo. That means the layout is set, and the valve, toilet, vanity, tile and lighting are chosen and ordered.
- Building permit. Under the Massachusetts building code (780 CMR 105.3.1), the building official must issue or deny a permit in writing within 30 days of filing. Complete applications move faster.
- Somerville paperwork. Applications go through the city's online portal, and the ISD Building Division lists the documents a contractor must submit, including licenses, the signed contract, affidavits and a site safety plan. A missing document is the most common reason a permit sits.
- Plumbing permit. Under 248 CMR 3.00, the inspector must act on a plumbing permit application within two working days, though acting isn't the same as approving.
My Somerville building permit guide covers the full process.
Bathroom remodel steps, week by week
- Week 1: protect and demo. Floor protection, dust walls and, in pre-1978 homes, lead-safe containment. Then demo and haul-out. This is when we find out what's really behind the tile.
- Week 2: repairs and rough-in. Fix subfloor and framing, then the plumber and electrician run new lines. Under 248 CMR 3.00, new plumbing can't be covered until it's tested if required, and the inspector may require both a rough and a final inspection. The inspector must act within two working days of being notified.

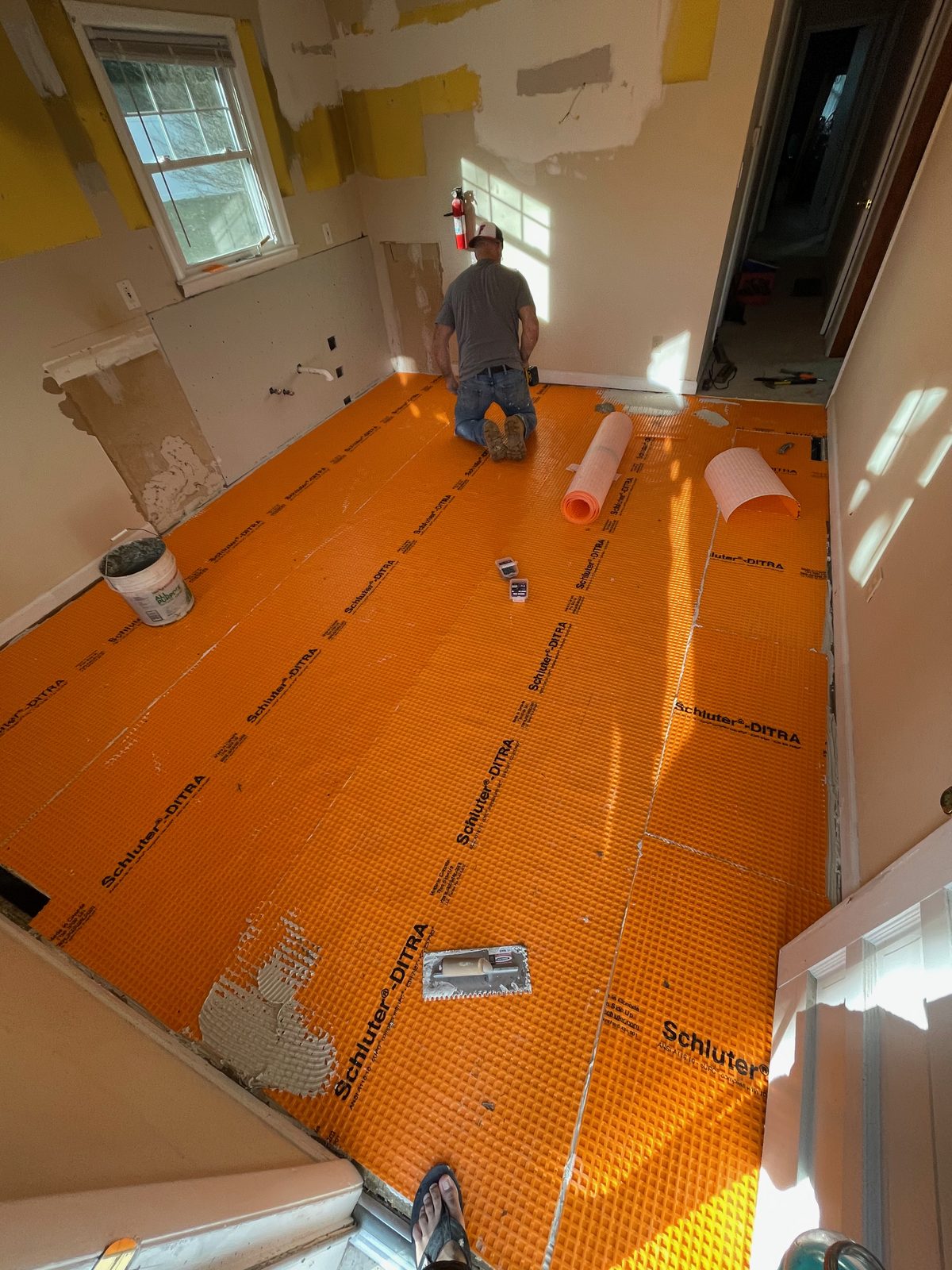

- Week 3: walls and waterproofing. Insulation where needed, cement board, waterproofing at the shower, and tile starts.
- Week 4: tile, grout and paint. Floor and wall tile, grout, then the vanity and paint.
- Week 5: fixtures and finals. Toilet, faucets, lights and fan get installed, the shower glass is measured and installed, and the final plumbing, electrical and building inspections close out the permits.
What causes delays in Somerville and Cambridge
- Incomplete permit applications or plan review questions.
- Inspection scheduling. Walls can't close until the rough inspections pass.
- Special-order tile and fixtures that arrive late or damaged.
- Hidden rot and old pipes. In early-1900s triple-deckers around Teele Square or East Somerville, I often find rotted subfloor at the toilet, old cast-iron drains or wiring that needs updating.
- Mid-project changes. A new tile choice after demo can cost a week.
- Work hours. Somerville allows construction Monday to Friday 7 a.m. to 7 p.m. and Saturday 9 a.m. to 7 p.m., per the city's Building Division page.
Small bathroom remodel timeline vs. a full gut
- Cosmetic refresh (paint, new floor tile, vanity swap with no pipe changes): often days rather than weeks. Somerville doesn't require a building permit for painting, tiling and flooring, but replacing a faucet or valve still needs a licensed plumber and permit.
- Full gut, same layout: the 3 to 5 week schedule above.
- Layout change or new bathroom: longer, because drains, vents and sometimes framing all change.
Living through a remodel with one bathroom
Many triple-decker units and Cambridge condos have just one bathroom. Here's how my clients get through it:
- Know your no-toilet days. I schedule so the toilet is out for as few days as possible, usually around demo and tile.
- Line up a backup: a gym, family nearby, a vacant unit in the building, or a short stay elsewhere during demo week.
- Use the kitchen sink for brushing teeth and washing up.
- Keep kids and pets out of the work area. In pre-1978 homes, lead-safe rules require a certified supervisor on site while work is underway, and containment is there for a reason. See my post on lead paint in older homes.
Will you be able to stay home during the work? Here is a phase-by-phase look at living through a renovation.
Before tile week, see the seven checks that catch hidden bathroom mistakes.
Need a hand?
If you want a bathroom done on a real schedule in Somerville, Cambridge, Medford or Greater Boston, book a free walkthrough. I'll map out your timeline, flag likely surprises, and send a written line-item budget, usually within 48 hours.
Frequently asked questions
How long does a small bathroom remodel take?
On my projects, a small full bathroom remodel usually takes about 3 to 5 weeks of construction once permits and materials are in hand. A cosmetic refresh with no plumbing changes can take just days.
How long does it take to get a bathroom remodel permit in Somerville?
Massachusetts code requires the building official to issue or deny a permit within 30 days of filing. A complete application with every required document is the best way to get it sooner.
What are the steps of a bathroom remodel?
Design and selections, ordering, permits, demo, framing and subfloor repairs, plumbing and electrical rough-in, rough inspections, waterproofing and tile, fixtures, then final inspections.
Can I live in my house during a bathroom remodel?
Yes, most people do. If it's your only bathroom, plan a backup for the few days the toilet is out, and keep kids and pets away from the work area.
See how I remodel bathrooms in Somerville and my published prices.
Read this next
Costs & BudgetsBathroom Remodel Cost in Massachusetts: What Greater Boston Homeowners Really PayBathroom remodel cost in Massachusetts: 2025 Boston figures, plumbing permits and the hidden cost drivers I find in Somerville and Cambridge homes.4 min read · Keep reading →
Permits & RulesDo I Need a Permit to Remodel My Bathroom in Somerville or Massachusetts?Do I need a permit to remodel my bathroom? A clear yes/no list for Somerville and Massachusetts: building, plumbing, electrical and lead rules.4 min read · Keep reading →
Kitchens, Baths & ExteriorsBathroom remodel regrets: 7 things to check before the tile goes upThe worst bathroom mistakes hide behind finished tile and show up months later. Here is what to check, and what to ask your contractor in writing.9 min read · Keep reading →
Home Care & SafetyCan You Live in Your House During a Renovation? A Builder's Phase-by-Phase AnswerDust, noise, no kitchen, kids and a dog. A Somerville builder explains what each phase means, how to contain it and when to pack a bag.9 min read · Keep reading →
Hiring & PlanningHiring a contractor in Massachusetts: 8 checks before you signRegistration, licenses, the written contract, the deposit and who pulls the permit — what Massachusetts law expects, in plain English.3 min read · Keep reading →
Permits & RulesHow long does it take to get a building permit? Somerville and Massachusetts timingHow long does it take to get a building permit in Somerville? The 30-day Massachusetts rule, what slows reviews, hearing timelines and how to speed it up.4 min read · Keep reading →
