How long does it take to get a building permit? Somerville and Massachusetts timing

How long does it take to get a building permit in Somerville? The 30-day Massachusetts rule, what slows reviews, hearing timelines and how to speed it up.

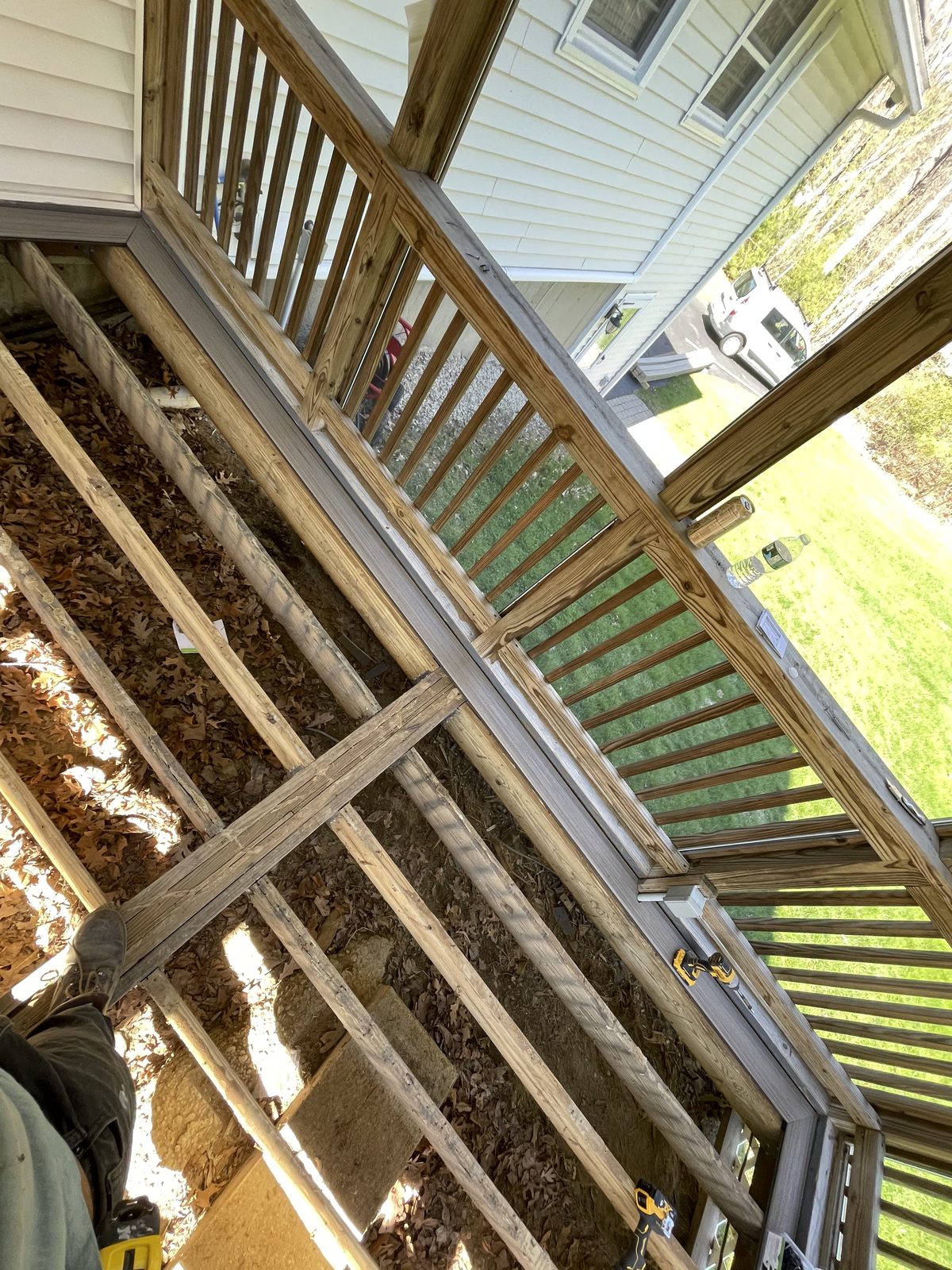

Porch and deck structure during a permitted rebuild

"How long does it take to get a building permit?" is one of the first things my Somerville clients ask, right after "how much?" The short answer: in Massachusetts the building official must act on your application within 30 days of filing, but that clock only helps you if the application is complete and needs no zoning or historic approval.

A clean, complete permit for interior work can move quickly. Anything that needs a zoning hearing, historic review or engineered plans takes longer. Below is how the rules work, what slows Somerville permits down, and how I keep my clients' projects moving.

The 30-day rule in the Massachusetts building code

Section 105.3.1 of the Massachusetts State Building Code, 780 CMR (10th edition) requires the building official to review your application and issue or deny the permit in writing within 30 days of filing. Here is what that means for you:

  • A denial has to be in writing and give the reasons.
  • If the official doesn't act in 30 days, the code points to a complaint or an appeal to the state Building Code Appeals Board.
  • Under section 105.3.2, an application is treated as abandoned 180 days after filing unless you pursue it in good faith. You can ask in writing for extensions of up to 90 days each.

The catch: the 30 days covers the building permit only. Zoning relief and historic approvals run on their own schedules, and those usually have to be done before the building permit is issued.

What slows down a Somerville building permit

Somerville files building permits through the Citizenserve portal. In my experience, delays almost always come from one of these:

  1. Incomplete applications. The Building Division lists required documents: the contractor's CSL, HIC registration for owner-occupied 1–4 unit homes, a signed contract, plans when required, Workplace Safety and Wage Theft affidavits, a Site Safety Plan and OSHA certification. If one is missing, you wait while it gets fixed.
  2. Zoning review. The permit has to show your project meets zoning, including setbacks, frontage and yard size. Porches, decks, dormers and additions get the most attention. My Somerville zoning guide explains the basics.
  3. Historic review. Work on a Local Historic District property, or demolishing a building 75 years or older, needs a separate Historic Permit in Citizenserve. That covers much of Somerville's 1900–1930 housing stock. See my guide to Somerville historic districts.
  4. Engineering. Structural changes like removing bearing walls, new beams or big openings need drawings someone can review. If the plans don't match the existing framing, expect questions.
  5. Trade permits. Electrical, plumbing and gas permits must be pulled by licensed trades. They run alongside the building permit, and one late trade can hold up the job.

How long does it take to get a building permit approved when you need a hearing?

If your project needs a special permit or a variance, state zoning law sets the outer limits:

ReliefPublic hearingDecision
Special permit (M.G.L. c. 40A, s. 9)Within 65 days of filingWithin 90 days after the hearing
Variance or appeal (M.G.L. c. 40A, s. 15)Within 65 days of the board receiving itWithin 100 days of filing

Both deadlines can be extended by written agreement. And those days only start once you file, which comes after design and the city's intake. Once you get relief, you still go back to ISD for the building permit itself. That's why I tell clients that a project needing a hearing is measured in months, not weeks.

A typical Somerville permit sequence

  1. Walkthrough, scope and existing-conditions measurements.
  2. Zoning check: does the work fit by right, or does it need relief?
  3. Historic check: is the property in a Local Historic District, or is anything being demolished?
  4. Drawings, stamped by an architect or engineer if needed.
  5. File a complete application in Citizenserve and pay the review fee.
  6. Answer reviewer comments fast.
  7. Permit issued and posted on site, then trade permits and inspections.

Want to see how busy the city is? My analysis of Somerville's 7,174 permits from the last 12 months shows which project types are most common.

How long does it take to get a building permit for a deck?

Decks and porches are rarely slowed down by the carpentry. What slows them is zoning, since setbacks matter in Somerville's tight lots, plus footing and framing details. A rebuild that keeps the same footprint usually moves faster than a new or larger deck. If your porch is failing, read my porch and stair safety guide first.

How a contractor or owner's rep speeds it up

  • Run the zoning and historic checks before design, not after.
  • Submit a complete package the first time, with matching costs, plans and affidavits.
  • Book the electrician and plumber early so their permits don't lag.
  • Answer reviewer comments the same day.

That is a big part of what an owner's representative does.

Builder's tip: Never start demolition "just to get ahead" while the permit is pending. Somerville requires permits before work starts. If you open a wall early and find a problem, you may have to redo the plans and start the review again.

Need a hand?

I pull permits in Somerville, Cambridge, Medford and Greater Boston, and I build the permit timeline into every schedule. Book a free walkthrough and I'll send you a written line-item budget, usually within 48 hours.

Frequently asked questions

How long does it take to get a building permit approved in Massachusetts?

The State Building Code, 780 CMR 105.3.1, requires the building official to issue or deny a permit in writing within 30 days of filing. Zoning or historic approvals add their own time on top.

How long does it take to get a building permit for a deck?

It depends mostly on zoning and the structural details. A same-footprint rebuild with complete footing and framing plans usually moves faster than a new or larger deck that needs a zoning check or relief.

Can I start work while my building permit is pending in Somerville?

No. Somerville's Building Division says permits must be obtained before work starts and displayed at the job site.

How long is a building permit application valid in Massachusetts?

Under 780 CMR 105.3.2, an application is considered abandoned 180 days after filing unless it is being pursued in good faith or a permit has been issued. The building official can grant written extensions of up to 90 days.

See the towns I work in, with local permit notes, and how I price work.

Read this next

  1. Permits & RulesSomerville building permit portal: how to apply, pay, track and search permitsSomerville building permit portal guide: apply on Citizenserve, upload the right PDFs, pay, track status, book inspections and search permits by address.4 min read · Keep reading →
  2. Home Care & SafetyRenovating in winter in Somerville: which projects make sense and which to wait onPlanning a winter renovation in Somerville? Which interior projects work in the cold, which to save for spring, and how to line up permits now.3 min read · Keep reading →
  3. Permits & RulesHow to get a building permit in Somerville: a homeowner's step-by-step guideWho can pull the permit, what you'll need, which jobs need one, and the energy-code rules that apply to Somerville renovations — in plain English.3 min read · Keep reading →
  4. Permits & RulesThe Somerville zoning ordinance explained: a plain-English guide for homeownersThe Somerville zoning ordinance in plain English: where to find the code and zoning map, NR vs UR districts, the ZBA, and rules for dormers and ADUs.4 min read · Keep reading →
  5. Hiring & PlanningHow long does a kitchen remodel take? A phase-by-phase Greater Boston timelineHow long does a kitchen remodel take in Somerville and Greater Boston? A phase-by-phase timeline: design, permits, cabinets, inspections and counters.4 min read · Keep reading →
  6. Hiring & PlanningWhat an owner's representative does — and when you need oneYou have plans — or a clear idea. Here's who turns them into a finished project, on budget, without you living on the job site.3 min read · Keep reading →

Have a question about your project?

Plans, a sketch or just an idea — talk to me. You'll get honest advice and a clear written budget and schedule.

Free: a 30-minute call or a walkthrough of your home.

Prefer to write? Send me your project details. I reply within one business day.
